How should I record drydock in Delays ?

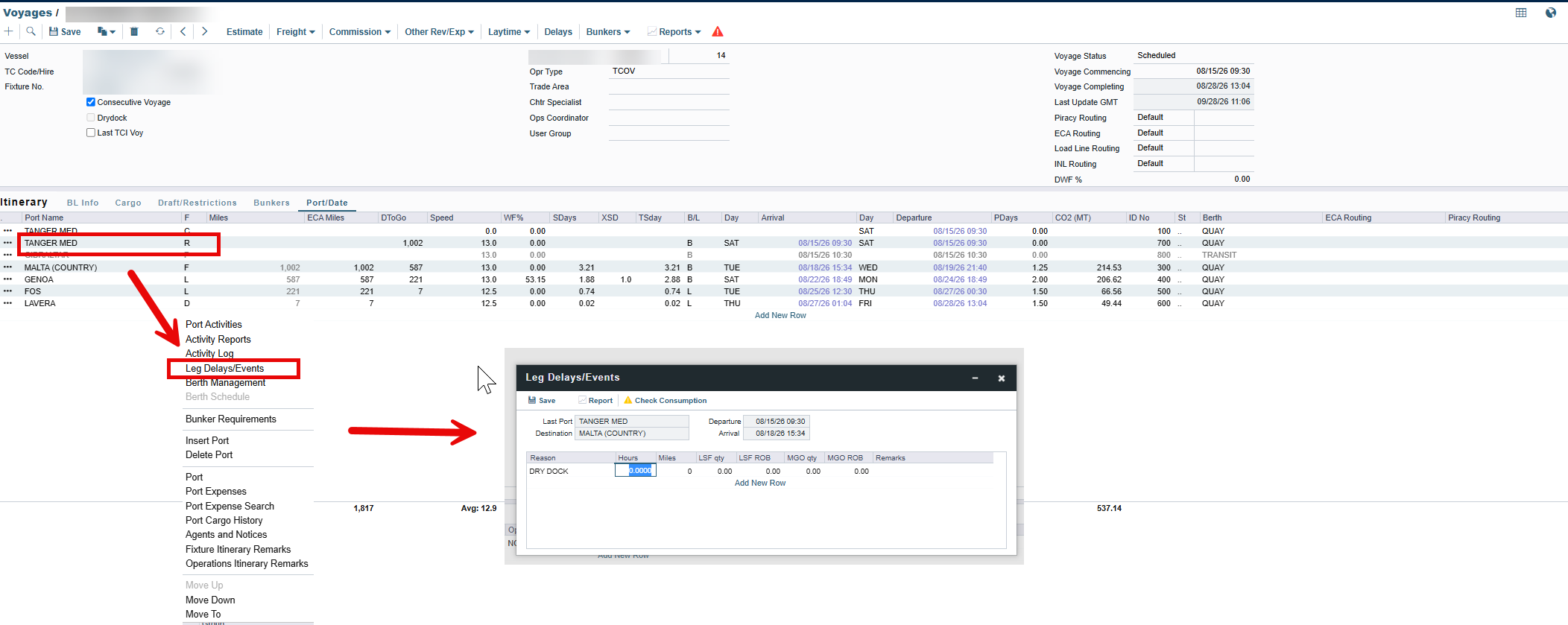

  1. Open the voyage and go to the itinerary.

  1. Add a line for the dry-dock port and mark its port function as R. Use the arrival and departure times that reflect when the vessel went off hire and when offhire ended

  1. Open the delay information for that port call and record the dry-dock period there.



  1. Also record the same period in the Delays section of the main menu. The dry dock needs to be entered in both places.

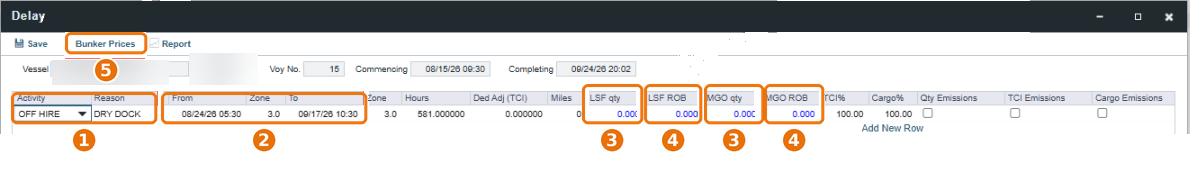

The screen below shows a completed entry, with the key fields numbered.


No.

Field

What to enter

1

Activity / Reason

Activity OFF HIRE, Reason DRY DOCK.

2

From / To

The dry-dock period: the date and time the vessel went off hire and the date and time it came back.

3

LSF qty / MGO qty

The bunkers used by the owners during the dry-dock period.

4

LSF ROB / MGO ROB

The bunker ROBs when the vessel was redelivered.

5

Bunker Prices button

Opens the bunker prices for the entry, where you add the prices for the bunkers (see question 5).

Deducting the dry-dock period from hire. The Delays entry also has a TCI Daily Cost field. This is the daily cost that is deducted from the hire payment for the dry-dock period.

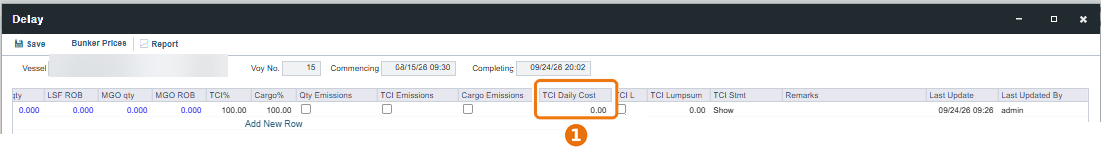

1  TCI Daily Cost: the daily cost to be deducted from the hire payment for the dry-dock period.


How do I add the bunkers the owner supplied during dry dock?

Owner-supplied bunkers are entered like any other bunkers, but against their own bunker requirement and marked so that they are not treated as charterer-paid.

  1. On the voyage, add a new bunker requirement for the dry-dock port.

  1. Add the bunker lifting against that requirement: quantity, grade, and the price the owner paid (or the agreed price for the off-hire bunkers).

  1. If the owner paid for the bunkers on their own account, mark the lifting accordingly .

  1. Save, then check the ROB after the lifting against the activity report for the same date.
